The Cost Structure Workflow slide presents a table outlining four key steps, their owners, durations, and statuses. Steps include Base Cost Lock-in (Procurement, Contract Signing, Stable), Consumables Negotiation (Supply Chain, Post-Contract, Negotiable), Ops Data Collection (Operations, Initial Phase, Ongoing), and Packaging Standards Finalization (Ops & Procurement, After Data, Pending).
Cost Structure Workflow
{ "headers": [ "Step", "Owner", "Duration", "Status" ], "rows": [ [ "Base Cost Lock-in", "Procurement", "Contract Signing", "Stable ✓" ], [ "Consumables Negotiation", "Supply Chain", "Post-Contract", "Negotiable" ], [ "Ops Data Collection", "Operations", "Initial Phase", "Ongoing" ], [ "Packaging Standards Finalization", "Ops & Procurement", "After Data", "Pending" ] ] }
Source: Slide 3 – Cost Structure & Key Negotiation Points
Speaker Notes

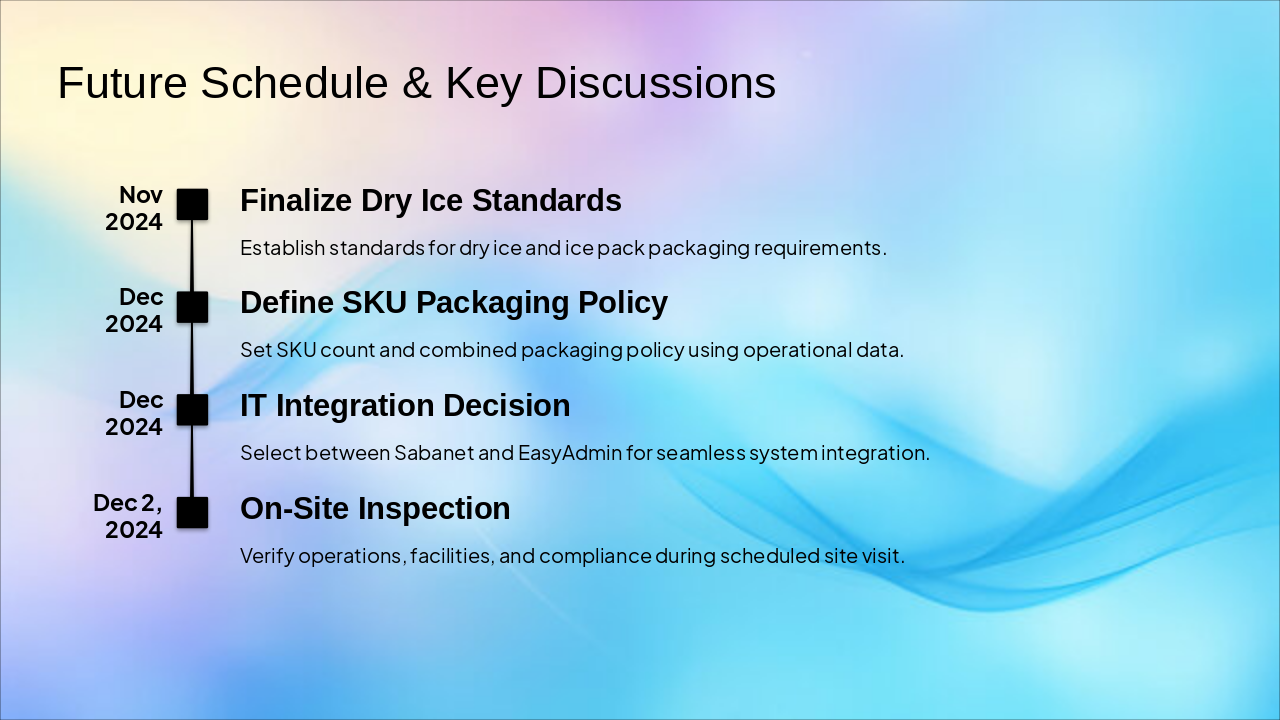

Headline: “Cost structure is stable, but additional negotiations based on item characteristics are required”. Flowchart: Base Cost (Stable) → Consumables (Negotiable) → Packaging (Pending). Bullets: No sudden price increases post-contract; separate consumables negotiations (dry ice, ice packs); packaging standards (SKU) after ops data. Section 1: Cost Structure - No sudden price increases after contract signing - Separate negotiations for consumables (dry ice, ice packs) - Combined packaging standards (SKU count) to be decided after operational data. Section 2: Risks & Considerations - Manual invoice tasks increase work complexity - SKU coding and product name mapping critical during initial operations - Maintain packaging by temperature zone (frozen/refrigerated) - Phased rollout (start 50%) to reduce risk. Section 3: Future Schedule & Key Discussions - Finalize dry ice/ice pack packaging standards - Define SKU & combined packaging policy - Decide IT integration (Sabanet / EasyAdmin) - On-site inspection (12/2) to verify operations. Design style: Modern visual style with color accents, infographic layout, clean typography, subtle gradients.
