Slide 1 - Executive Summary
The executive summary outlines the purpose of developing a 269,000 sq ft facility from December 2026 to December 2028. The key risk is a delay in the infusion target date.
Executive Summary
- Purpose: Develop 269K sq ft facility

- Timeline: Dec 2026–Dec 2028

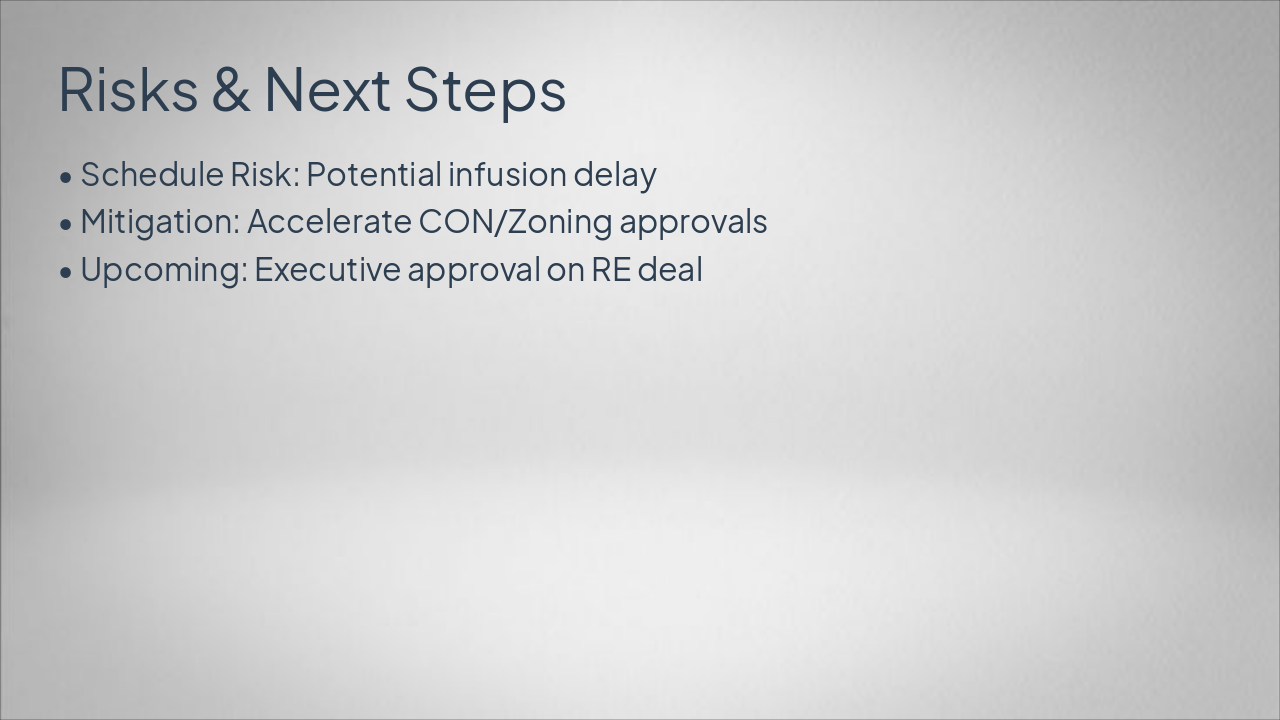

- Key Risk: Infusion target date delay
Source: Bruno Project Executive Update
